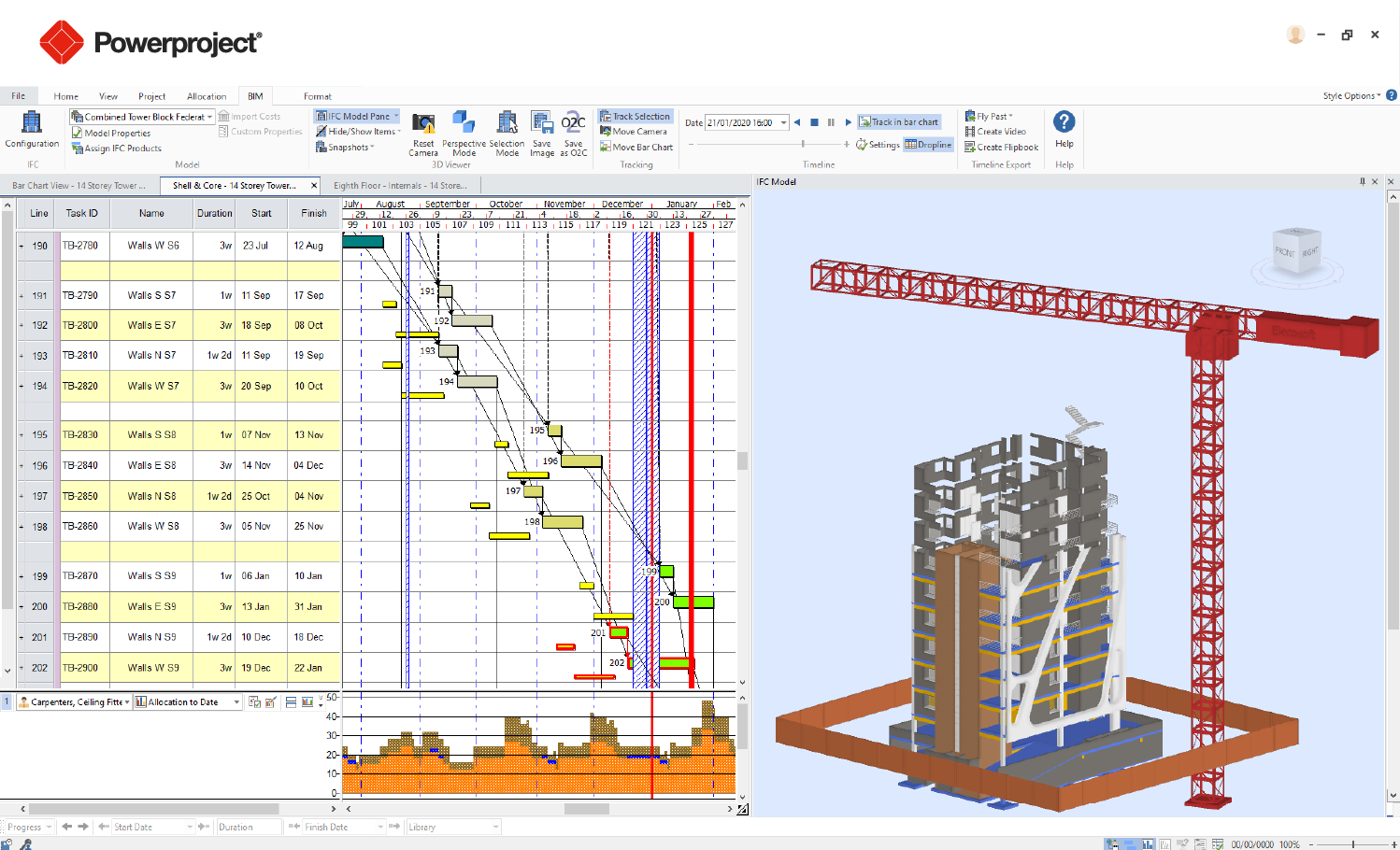

Asta Powerproject BIM

Comprehensive 4D Planning

Key Features of Asta Powerproject BIM

R

IFC Import

Supports industry-standard IFC files (from Revit, ArchiCAD, Tekla, etc.)

R

Linking Model to Tasks

Drag and drop model elements to Gantt tasks to create 4D links

R

Color-Coded Task Visualization

See which components are associated with each task using colors in the 3D view

R

Split and Merge Model Elements

Divide or combine elements to better match the task breakdown

R

Model Comparison / Revisions

Handle updates to models (e.g., revised IFCs) without losing links

R

Model Navigation

View, rotate, zoom, and explore the 3D model inside Asta

R

4D Construction Simulation

Animate the build sequence over time to visually simulate project progress

R

Model-Based Progress Tracking

Update model progress visually alongside actual schedule progress

R

Clash / Logic Checks

Identify sequencing errors visually (e.g., walls before foundations)

R

Offline or Cloud

Can work with models stored locally or shared via cloud platforms

Benefits of Asta Powerproject BIM

L

Improves Communication

4D visuals help explain plans clearly to stakeholders, even non-technical ones

L

Links Time and Space

Seeing when and where elements are built reduces confusion on-site

L

Integrates with Estimating & Costs

When paired with tools like Bidcon BIM, helps with 5D planning (costs + schedule + model)

L

Enhances Collaboration

Shared 3D views help align architects, planners, and contractors around the same plan

L

Reduces Build Errors

Visualizing sequences reveals conflicts or errors before construction starts

L

Supports Lean Construction

Allows better planning of workflows, minimizing waste and idle time

L

Better Progress Tracking

Visual progress updates help spot deviations from plan early

L

Minimizes Rework and Claims

Clear build logic and evidence of planned vs actual can reduce legal disputes

Asta Powerproject BIM Workflow

Step 1: Import Your BIM Model (IFC Format)

  • Start by importing a 3D model in IFC format (open BIM standard).
  • Models can come from Revit, ArchiCAD, Tekla, or other BIM tools that export IFC.

Step 2: Create your construction schedule using Asta Powerproject as usual:

  • Activities/tasks
  • Durations
  • Logic (dependencies)
  • Resources/costs (optional)

You can also import a schedule from MS Project, Primavera, or Excel if needed.

Step 3: Link Model Elements to Tasks

  • Open the BIM viewer pane (inside Asta Powerproject BIM).
  • Select a task in the Gantt chart.
  • Then drag and drop one or more model components (walls, slabs, doors, etc.) onto that task.
  • This creates a 4D link between the task and the model element(s).

    Step 4: Visualize Task Sequences in 3D

    Use the built-in 3D viewer to:

    • Highlight linked components
    • View color-coded stages (based on planned dates, actual progress, or task status)
    • Navigate through time using the “Play” or “Time Slider” to see how construction will progress

    This is your 4D construction simulation — a timeline-linked model animation.

    Step 5: Update Progress (Visually & Numerically)

    • Update task progress manually or through site updates (e.g., Site Progress Mobile).
    • The BIM view updates to reflect the current build state:
      • Completed tasks = components turn green (or configured color)
      • In-progress = orange, behind schedule = red, etc.

    This visual feedback helps identify delays or sequencing issues faster than spreadsheets.

    Step 6: Handle Revisions (Model or Schedule)

    • If the IFC model gets updated (e.g., design changes):
      • You can reimport the new version
      • Asta will attempt to preserve existing links
      • You can also use the “compare” feature to spot changes between model versions

    This supports model-based change management.

    Step 7: Generate Reports or Export 4D Video

    • Take snapshots of model stages for presentations
    • Export a 4D animation video (MP4 or AVI) to share with clients or teamsInclude task names, dates, colors, and camera angles

    This is especially helpful for:

    • Tender presentations
    • Client progress reviews
    • Site team briefings
